Real-Life Project Plan Samples: Find the Perfect Example or Template for Any PM Methodology

By Lulu Richter | October 14, 2024

Project plans provide a clear roadmap for achieving project goals. We’ve rounded up more than a dozen of the most helpful real-world examples and images so you can find guidance no matter what project management methodology you choose.

Included in this article, you’ll find the following:

Project Plan Examples

From Agile to CPM to Six Sigma and more, these examples showcase various approaches to project planning. Each example highlights how teams can tailor project plans to specific projects. Use these examples as inspiration to create a plan that suits your methodology and keeps your team on track.

The basic project plan example lays out the different elements of a project plan, step by step. Use it as a baseline, and add or replace the sections that correspond to your chosen methodology.

Remember, you can format a project plan in any way that best suits the needs of your project. These project plan templates for PowerPoint are a great resource for teams that need to present a project plan to stakeholders. You can also create a comprehensive, shareable document with one of these project plan templates for Microsoft Word.

Basic Project Plan Example

In this example project plan, a fitness studio company creates a complete overview of how to approach a website redesign with AI integration. It takes you through all the key elements of a basic project plan, including scope, objectives, timeline, roles, budget, success metrics, and more.

To see this example in a free, filled-out template, scroll to the download link in the next section.

Be Strong Fitness Studios Website Redesign With AI Integration

  1. Executive Summary: Be Strong Fitness Studios is embarking on a website redesign project focused on integrating AI tools to enhance the user experience and improve operational efficiency. The primary goal is to incorporate AI-driven functionalities to create a more personalized experience by pairing members with trainers and fitness classes based on their preferences and fitness goals. Additionally, the AI integration will simplify class scheduling and cancellations, making the process easier and more flexible for users. The project will focus solely on seamlessly implementing these AI solutions into the existing website infrastructure, ensuring that members can enjoy these new features without disruption. By leveraging AI, we aim to streamline operations and provide an upgraded, user-friendly digital platform for our members.

  2. Project Scope: The scope of this project is limited to the integration of AI tools into Be Strong Fitness Studios’ existing website. This includes the development and implementation of AI functionalities to improve member-trainer and class matching based on individual fitness goals and preferences. Additionally, the scope covers the integration of AI-driven features to simplify the process of scheduling and canceling classes to provide a smoother user experience.

    The project will focus on enhancing the existing website infrastructure without any major redesigns of the site’s layout or content. Testing will be conducted to ensure that the AI tools function properly across all devices and that any issues affecting user experience are resolved.

    Exclusions from the project include changes to the visual design of the website, third-party systems, or internal business processes unrelated to the AI integration. The project will conclude with a soft launch of the AI tools, followed by training for staff to manage and support the new functionalities.

  3. Objectives and Goals

    1. Integrate AI tools to provide personalized trainer and class recommendations based on member preferences.
    2. Implement an AI-driven scheduling system that reduces class booking time by 30 percent.
    3. Ensure the website is fully optimized for mobile, providing a seamless experience on all devices.
    4. Develop AI-generated training plans that adapt to each member’s fitness level, preferences, and goals, providing personalized workout routines that evolve with their progress.
    5. Reduce post-launch technical issues to less than 5 percent through extensive testing and a phased rollout.
    6. Provide staff training to ensure internal teams can effectively support and guide members through the new AI features.
    7. Enhance the overall user experience. Aim for a 90 percent user satisfaction rating within three months of launch.

  4. Project Timeline and Milestones

    Project PhaseKey MilestonesEstimated Completion
    Phase 1: Requirements Gathering and PlanningFinalize AI functionality requirements.Week 2
    Assess website infrastructure compatibility with AI tools.Week 3
    Complete the project plan, timeline, and resource allocation section.Week 4
    Phase 2: AI Tool Selection and DesignSelect appropriate AI tools for class and trainer matching.Week 6
    Finalize the system architecture and the design integration plan.Week 8
    Complete back-end infrastructure setup for AI integration.Week 12
    Phase 3: AI Integration DevelopmentImplement AI-driven class and trainer matching.Week 16
    Develop AI-powered scheduling and cancellation features.Week 20
    Ensure full functionality of AI with existing website infrastructure.Week 22
    Phase 4: Testing and Quality AssuranceConduct cross-device functionality and usability testing.Week 24
    Test AI accuracy and user interaction.Week 26
    Complete security and performance tests.Week 28
    Phase 5: Training and Soft LaunchTrain staff on AI tools and website management.Week 32
    Launch soft rollout to a small user group for feedback.Week 33
    Refine based on beta testing feedback.Week 34
    Phase 6: Full RolloutLaunch the full AI-powered website to all members.Week 37

  5. Roles and Responsibilities

    RoleResponsibilitiesTeam Leader(s)
    Project ManagerOversee project timeline, resources, and deliverables; coordinate among teams.Krista Ahmed, Project Manager
    Web Development TeamImplement and integrate AI tools into the existing website infrastructure.Leigh Gibbs, Lead Developer
    AI SpecialistsDevelop and customize AI functionalities for trainer and class matching and scheduling.Fiorella Fitzgerald, Lead AI Engineer
    UI/UX DesignersEnsure the user interface is intuitive and aligns with AI features; focus on mobile responsiveness.

    Henry McNeal, Lead UI Designer

    Mateus Tobin, Lead UX Designer

    Quality Assurance (QA) TeamConduct functionality, performance, and security testing across devices and browsers.Jamal King, QA Team Leader
    Fitness TrainersProvide input on how the AI tools should match members with trainers and classes based on their personal fitness goals.Petrus Nishimura, Trainer Lead
    Customer Support TeamAssist members with navigating the new AI tools, and manage user feedback post-launch.Sarah Goodwin, Customer Support Manager
    IT Support TeamHandle post-launch technical issues, and ensure that server/hosting infrastructure supports the new AI tools.Tamika Marshall, IT Lead
    Executive SponsorApprove major decisions; oversee project alignment with overall business goals.Jonathon Wong, CTO
    Training TeamTrain internal staff on how to use and manage the new AI features.Kiran Gupta, Training Manager

  6. Cost Baseline

    Expense CategoryAllocated
    AI Software/Tools$40,00
    AI Specialist Costs$60,00
    Hosting and Infrastructure Upgrades$10,000
    Testing and Quality Assurance$15,000
    Training and Support Costs$5,000
    UI/UX Design Costs$20,000
    Web Development Costs$50,000
    Total Estimated Cost Baseline$200,000

  7. Cost Control Plan

    • Monitoring: The project manager will track all actual costs against the cost baseline throughout the project’s phases. Costs will be reviewed monthly to identify any deviations or risks of exceeding the budget.
    • Variance Management: A variance threshold of 10 percent will be established. If actual costs exceed the baseline by more than 10 percent, corrective actions (such as adjusting scope, resources, or timeline) will be evaluated and implemented.
    • Updates and Adjustments: If necessary, adjustments to the cost baseline will be made through formal change control processes, ensuring that any changes to the budget are documented and approved by the project sponsor.
    • Milestone Cost Reviews: At key project milestones (such as the completion of AI development and testing phases), a cost review will be conducted to ensure the project remains on track financially.

  8. Risk Management Plan

RiskImpactLikelihoodMitigation Plan
Project timeline could extend, leading to increased costs.HighMediumAllocate additional development resources and conduct regular progress check-ins to ensure timely completion.
Project may exceed budget, affecting overall financial performance.MediumMediumEstablish a strict budget control process, review expenses regularly, and adjust the scope or resources if necessary.
AI tools may not function as expected, reducing user satisfaction.HighLowConduct thorough testing throughout the development phase, and allocate time for troubleshooting and bug fixes.
Members may struggle to use the new AI features, which may impact engagement.MediumHighProvide clear user guides, offer training sessions, and implement a soft launch to gather feedback and make improvements.
Breach of user data or system security could harm the brand’s reputation.HighLowImplement advanced security measures, perform rigorous security testing, and regularly update the system.

  1. Communication Plan: The overall project team will hold twice-weekly status meetings to discuss progress, address roadblocks, and review upcoming tasks. The development team will hold daily standups during the AI integration development and testing and quality assurance phases. Key stakeholders, including the project sponsor and executive team, will receive monthly progress reports that highlight achievements, upcoming milestones, budget updates, and potential risks. For any critical issues or decisions that require immediate attention, the team will schedule ad-hoc meetings. The project management platform will centralize all project documents, timelines, and communication to ensure that all team members can access the latest information. At key milestones, such as after AI integration and testing, the team will conduct post-phase reviews to gather feedback and make necessary adjustments. Clear communication guidelines will designate specific team leads to disseminate information to their respective teams.

  2. Project Evaluation and Success Metrics: The evaluation of the Be Strong Fitness Studios website redesign project focuses on assessing the effectiveness of AI integration, user adoption, and overall project delivery. The project successfully enhanced user experience by incorporating AI-driven class and trainer matching, as well as by improving scheduling functionality. Success metrics include the smooth integration of AI tools, a reduction in class booking and cancellation times, and positive user feedback on personalized training plans. Additionally, the project adhered to the budget and timeline, with minimal post-launch issues reported.

    • Success Metrics:
      • AI functionality adoption by 80 percent of members within three months
      • 50 percent reduction in time spent booking and canceling classes
      • 90 percent user satisfaction rating for the new website features
      • Less than 5 percent technical issues reported post-launch

Downloadable Example Basic Project Plan Template

Basic Project Plan Template Example

Download an Example Basic Project Plan Template for
Microsoft Word  | Google Docs

Download a Blank Basic Project Plan Template for
Microsoft Word  | Google Docs

Use this comprehensive project plan template to organize and manage your project from start to finish. It provides a clear structure to define scope, set objectives, and monitor project progress. To use the template, simply fill in each section with your project’s details. You can download the template pre-filled with the example data provided above or download a blank version to customize for your own project. To adapt it to your chosen project management methodology, simply add sections using the following examples as guidance.

To learn how to create your own project plan from scratch, see this guide to writing the perfect project plan.

Example Waterfall Project Plan

Waterfall is a linear project management methodology where teams complete each phase sequentially before moving to the next. Unlike Agile or other iterative methods, a Waterfall project plan is more rigid: Teams define tasks and timelines upfront, which makes it well-suited for Gantt charts.

This method is great for projects with clear dependencies, such as the following kitchen renovation project:

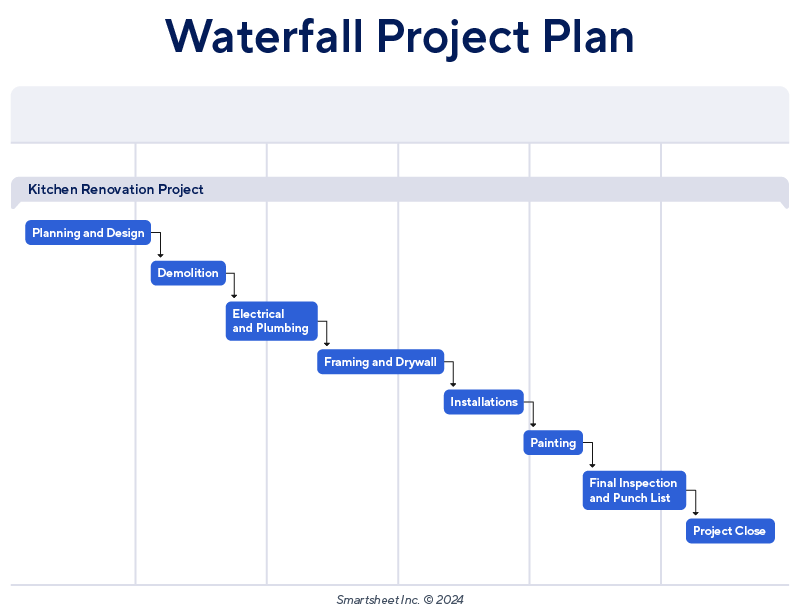

Waterfall Project Plan Example

Sample Gantt Chart Project Plan

Gantt charts are also useful for planning tasks on simple projects. A Gantt chart is a visual timeline that shows the start and end dates of tasks. In this example, the team lays out tasks on a Gantt chart for a program development and launch project.

Gantt Project Plan Example

“I typically include Gantt charts when I need a visual representation of tasks over time,” says Sahana Ramlugan, Marketing and Project Manager at Adepteq. “They’re particularly helpful for stakeholders who prefer a clear, linear timeline of project phases.”

Sahana Headshot c

Teams can also use a tool like Excel to create Gantt charts for a project plan. See this roundup of project plan templates for Excel to learn more.

Critical Path Method Project Plan Example

The critical path method (CPM) is a project management approach where you identify the most important tasks in a project — those that must be completed on time to avoid delays. This example project is complex and includes many dependencies, making it perfect for CPM.

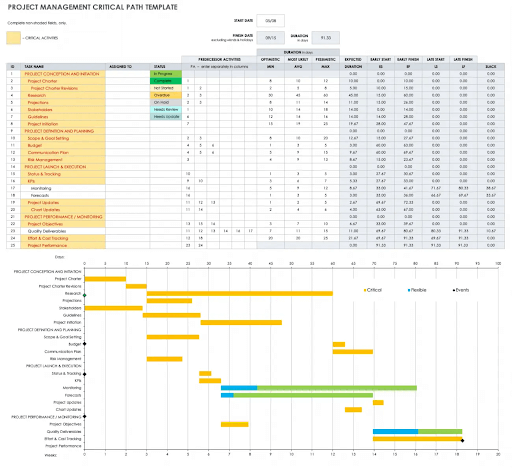

Project Management Critical Path Template

“When planning projects using CPM, I identify the longest sequence of dependent tasks,” says Ramlugan. “This method helps pinpoint where delays would impact the overall project timeline. CPM works best in projects where deadlines are fixed, such as software rollouts or construction projects, because it allows you to closely monitor crucial tasks.”

Agile Project Plan Examples

Project planning in Agile is iterative and flexible, with a focus on delivering work in short work segments, called sprints. Unlike traditional project plans that have fixed timelines and detailed upfront scope, Agile plans adapt continuously. Agile teams prioritize tasks dynamically and allow for frequent adjustments to the scope to meet project needs.

“On paper, there is no such thing as an ‘Agile project plan,’” says Hugh Smith, a software engineer with more than a decade of experience working in Agile environments. “A project plan is a concept that can only exist in the Waterfall methodology because it gives a timeline and declares the scope of a project, which are not Agile concepts.”

Hugh Smith

Instead, Agile developers will map out sprints or or iterations, focusing on delivering incremental progress, adapting to changes, and continuously refining the product based on feedback rather than following a fixed plan.

“In Agile, project planning is iterative and flexible,” says Ramlugan. “Unlike traditional methods, you focus on delivering value through smaller, manageable sprints. The emphasis is on adaptability and responding to change, rather than following a rigid plan. Planning in Agile happens continuously as feedback from stakeholders and team members guides the next phase. This allows you to make adjustments in real time.”

For example, imagine a development team is designing a customer loyalty mobile app so customers can earn points for rewards and receive personalized offers. Instead of dividing this project into milestones and tasks, an Agile project manager would divide it into sprints and features. For example, the first sprint might include user registration and onboarding features, such as a user profile management feature that allows users to update personal information and preferences in the app.

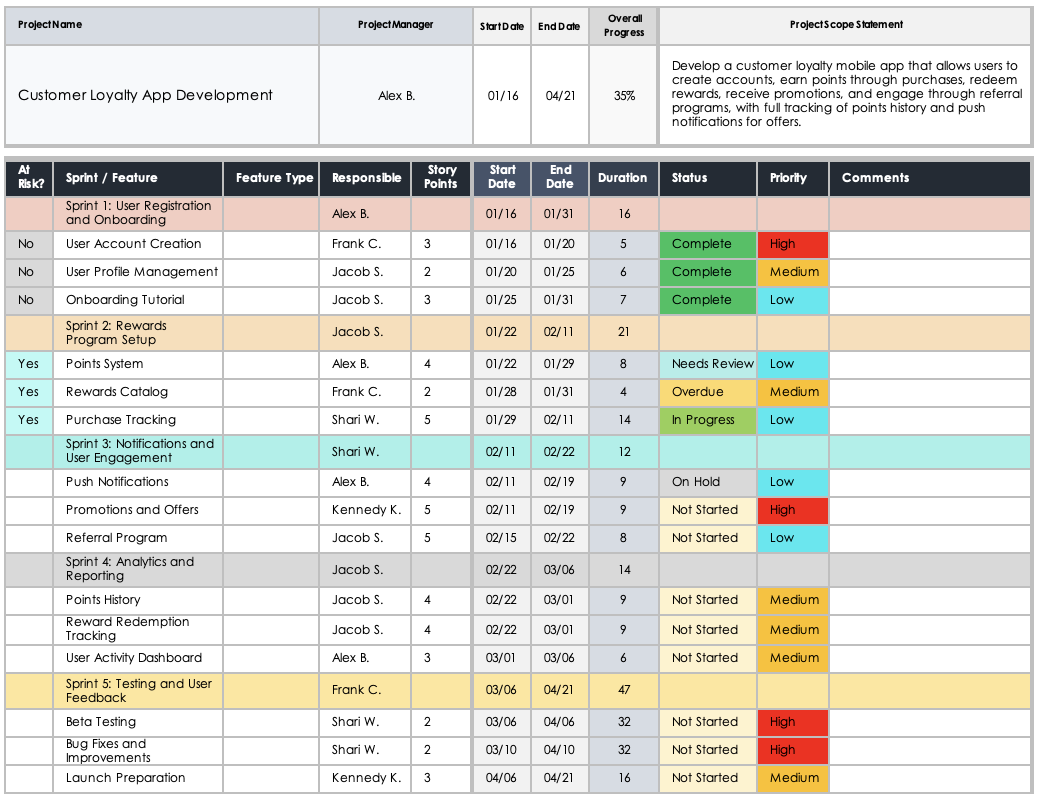

Here is an example sprint planning spreadsheet:

Sprint Planning Example

To find pre-formatted spreadsheets like this one, see this collection of free sprint planning templates.

Products that have not yet been assigned to a sprint live in the product backlog, which is a prioritized list of features, enhancements, and tasks that need to be completed for a project. The product backlog serves as a dynamic to-do list for the development team.

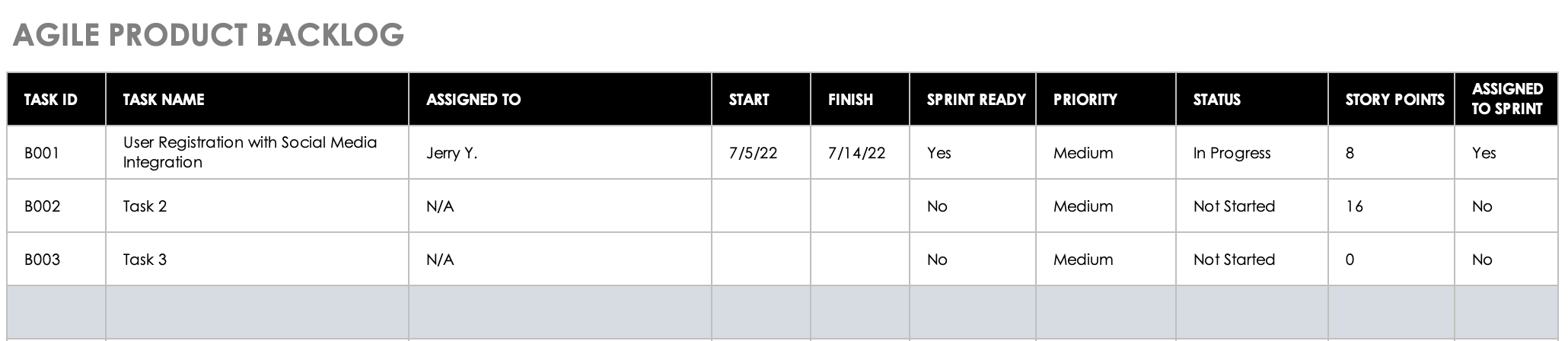

Here is an example of a short product backlog:

Agile Product Backlog

Sample Agile Project Plan With a Gantt Chart

In Agile, Gantt charts can be used for high-level planning or to communicate project timelines and milestones to stakeholders who need a visual representation of progress, even in an iterative environment. They help teams map out sprints, track dependencies, and align broader project timelines while remaining flexible.​

“In Agile, Gantt charts can sometimes feel too rigid, but they can still be useful in hybrid environments where teams need a high-level view of major milestones,” says Ramlugan.

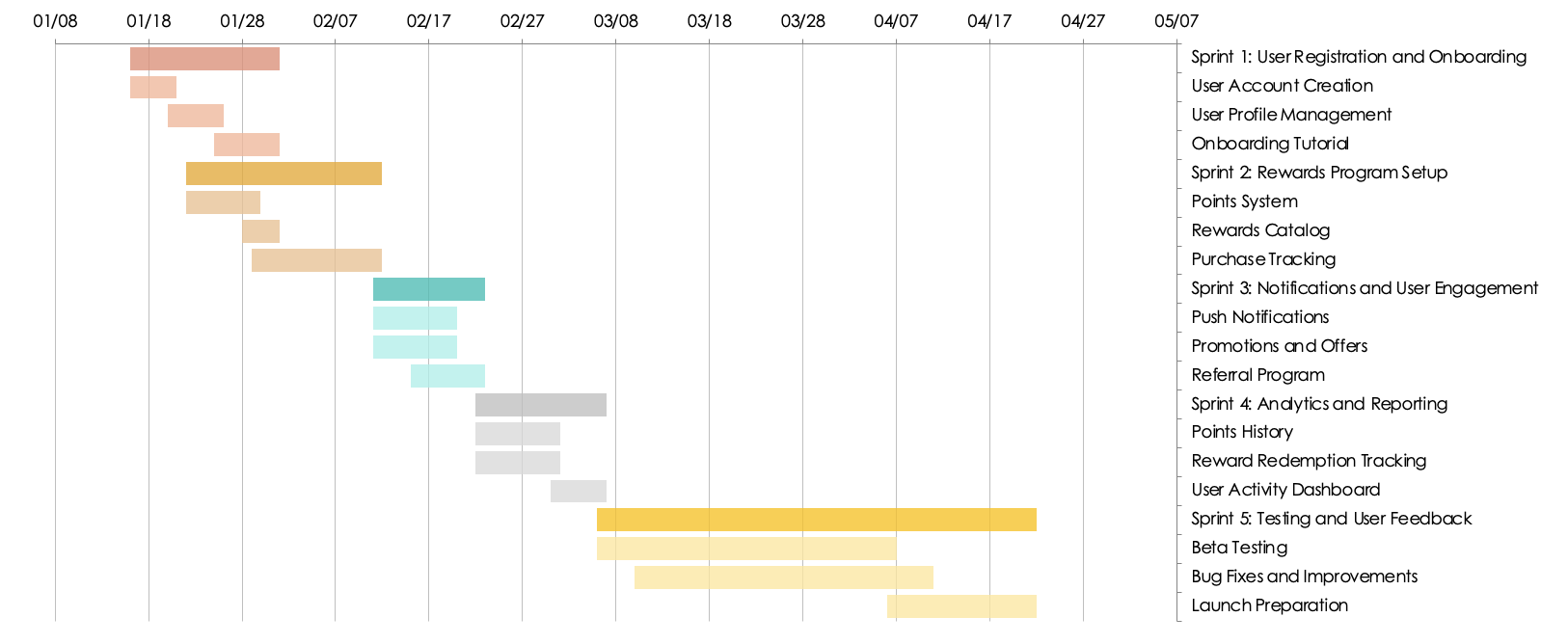

This example Gantt chart depicts the sprint planning spreadsheet from the previous example as a color-coded Gantt chart:

Agile Gantt Chart Example

Kanban Project Plan Example

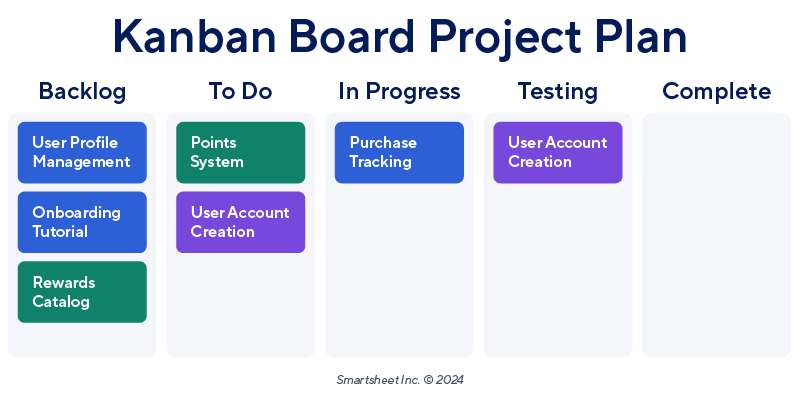

You can also organize tasks in an Agile project using a Kanban board. A Kanban board is a visual tool that helps teams track work progress in simple status columns (often To-Do, Doing, and Done). This example illustrates how a project manager might arrange tasks on a Kanban board to insert into their project plan:

Kanban Board Project Plan Example

You can always edit the column labels to suit the needs of your project. “How complicated a Kanban board is depends on the team,” says Smith. “Are we OK with To-Do, In Progress, and Done? Or do we need to add a Blocked or Testing column?”

Example Extreme Programming (XP) Project Plan

Some Agile teams opt to use extreme programming (XP), another Agile methodology. An XP project plan includes short, iterative cycles with detailed user stories and constant feedback loops, but is more rigid than other Agile methods, with constant communication between developers and the customer.

Here is an example of the XP process for a single user story:

User Story: As a user, I want to see a confirmation message when I save my profile changes so that I know my updates were successful.

  1. Planning Meeting: The iteration starts with a planning meeting where the team discusses and selects user stories.
  2. Task Breakdown and Assignment: The team then estimates the effort for this user story and breaks it down into tasks:
    • Task 1: Design the confirmation message UI.
    • Task 2: Implement the back-end logic to confirm that profile changes were saved.
    • Task 3: Integrate the confirmation message with the Save function.
    • Task 4: Write automated tests for both front-end and back-end changes.
  3. Pair Programming and Continuous Integration: Developers work in pairs, with one coding and the other reviewing in real time. Each pair frequently integrates the code into the main branch and runs automated tests to catch issues early.
  4. Test-Driven Development (TDD): Developers write unit tests before implementing the code to ensure that the feature behaves as expected from the start. They run automated tests to verify that the confirmation message displays correctly when profile changes are saved. Finally, they conduct user acceptance tests (UAT) to ensure the feature meets the user’s needs and expectations.
  5. Daily Stand-Ups: The team meets daily for a brief stand-up meeting to discuss progress, obstacles, and what they will work on next.
  6. Customer Feedback: The team demonstrates the feature to the customer or product owner and gathers feedback to determine if the confirmation message meets the customer’s expectations.

Example Adaptive Project Framework (APF) Project Plan

Like Agile, the adaptive project framework (APF) is more flexible than a traditional project plan, allowing for adjustments as a project evolves. Unlike Agile, APF doesn’t only adapt the deliverables. Instead, it adapts the entire project process, including the methodology, to better fit evolving project needs.

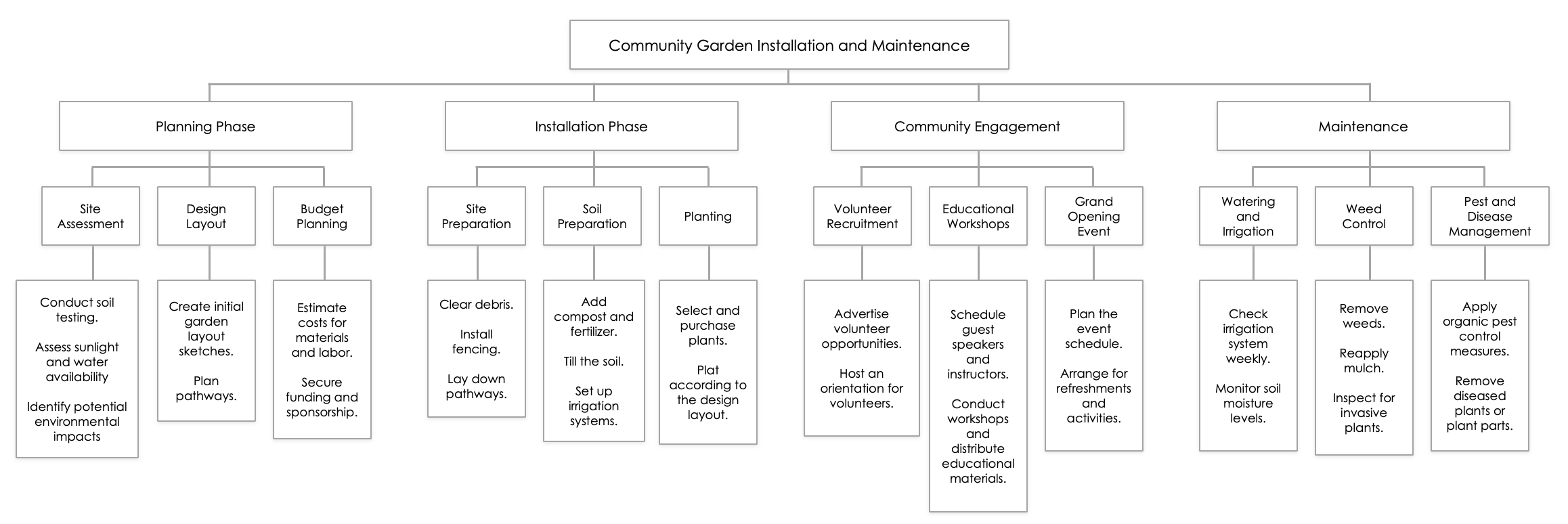

A team employing APF might create a work breakdown structure (WBS) — as in the example below — to break down project deliverables into smaller, manageable tasks in the project plan:

WBS APF Project Plan Example

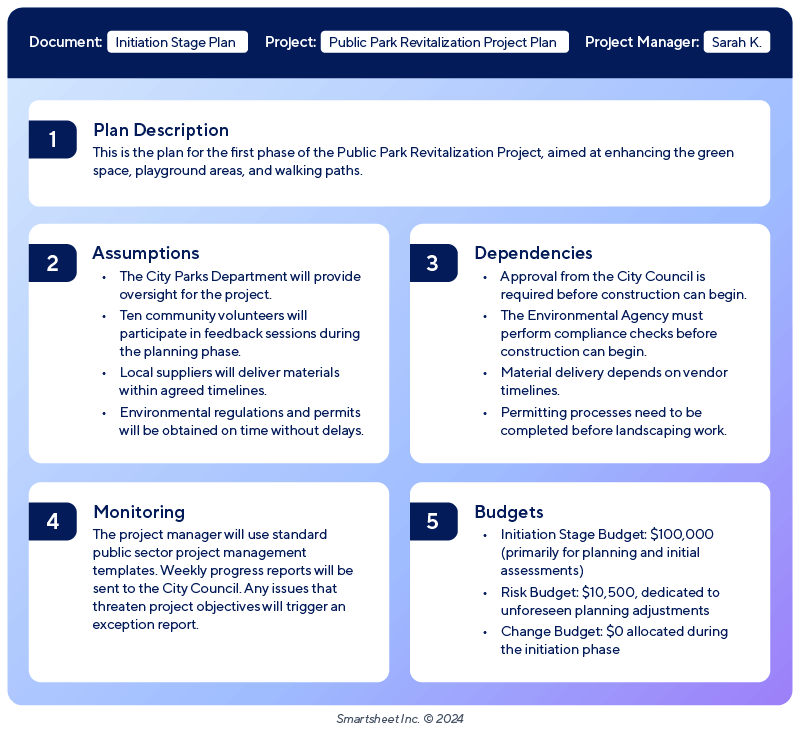

PRINCE2 Project Plan Example

PRINCE2 project plan outlines how and when project objectives will be achieved, including products, activities, and resources. In this initiation stage project plan, the team maps out project assumptions and task dependencies, and allocates a budget for this phase. Buffer resources are an important part of PRINCE2.

PRINCE2 Project Plan Example

“PRINCE2 is all about structure,” explains Ramlugan. “Planning in PRINCE2 requires breaking down the project into stages with defined objectives, resources, and timelines. Each stage is planned in detail, and teams review progress before moving to the next. This framework ensures control and accountability at every level, which is especially useful for large, complex projects where governance and stakeholder communication are key.”

Six Sigma Project Plan Example

Six Sigma project plans stand out because they use a structured, data-driven approach to improve processes. They focus on reducing errors and variations through the DMAIC (define, measure, analyze, improve, control) method. The customer acquisition process improvement example below shows a clear roadmap to improve process quality and efficiency.​

Get Rich Financial Services Customer Acquisition Process Improvement

  1. Project Description: The goal of this Six Sigma project is to improve the customer acquisition process for Get Rich Financial Services by reducing inefficiencies, optimizing lead generation, and increasing conversion rates. Currently, the process is hindered by high customer drop-off rates and lengthy onboarding times, which leads to a lower-than-expected customer acquisition rate. This project will apply the DMAIC methodology to identify root causes of these inefficiencies, implement targeted improvements, and ensure a streamlined and efficient acquisition process. By refining marketing efforts, reducing lead response times, and improving the customer onboarding experience, the project aims to increase the number of qualified leads and improve overall customer satisfaction, contributing to higher revenue growth for Get Rich Financial Services.

    Key metrics to be improved include lead conversion rates, customer onboarding time, and cost per acquisition, with an expected improvement of 20-30 percent in these key areas.

  2. Problem Statement: Get Rich Financial Services is experiencing lower-than-expected customer acquisition rates due to inefficiencies in the lead generation and onboarding processes. Current challenges include high customer drop-off during the onboarding phase, slow response times to leads, and inconsistent follow-up strategies, which result in a high cost per acquisition and missed revenue opportunities. These issues are impacting the company’s ability to grow its customer base and meet sales targets. This Six Sigma project aims to identify the root causes of these inefficiencies and implement process improvements to increase lead conversion rates and reduce acquisition costs.

  3. Goal Statement: The goal of this Six Sigma project is to streamline and optimize the customer acquisition process at Get Rich Financial Services by increasing lead conversion rates, reducing customer drop-off during onboarding, and lowering the cost per acquisition by 20 percent within six months. The project will achieve these improvements by identifying and addressing key inefficiencies in lead response times, follow-up strategies, and onboarding processes, ultimately enhancing overall customer satisfaction and contributing to revenue growth.​

  4. Team Roles and Responsibilities

RoleResponsibilityName and Title
Project SponsorProvide overall direction, secure resources, and ensure the project aligns with business goals. Act as the key decision-maker and approve major milestones.Jason Desjardins, Chief Marketing Officer
Project ChampionSupport the project at a high level, help remove obstacles, and ensure the project receives attention across departments.Hazel Christensen, Head of Customer Acquisition
Project Manager/Black BeltLead the project team, manage day-to-day operations, ensure adherence to the Six Sigma DMAIC methodology, track progress, and ensure project deliverables are met.Sasha Petrov, Senior Process Improvement Specialist
Green BeltsAssist the Black Belt in executing tasks within the DMAIC phases, perform data collection, analysis, and implement improvements.

Lori Garcia, Process Improvement Analyst

Romy Bailey, Marketing Analyst

Yellow BeltsAssist in project execution by collecting data, helping with process mapping, and supporting the Green and Black Belts in various tasks.

Brian Gorman, Junior Process Improvement Analyst

Steven Addison, Marketing Assistant

  1. DMAIC Phases:

    PhaseObjectiveKey Activities
    DefineClearly define the project’s purpose, scope, and key deliverables.
    • Develop the project charter: Outline the problem statement, goal statement, and scope.
    • Identify stakeholders and assemble the project team.
    • Conduct Voice of the Customer (VOC) analysis to understand customer acquisition challenges.
    • Create a SIPOC (suppliers, inputs, process, outputs, customers) diagram to map the acquisition process.
    • Set project milestones and establish a high-level timeline.
    MeasureCollect data to understand the current state of the customer acquisition process.
    • Develop a data collection plan that focuses on lead conversion rates, onboarding times, and cost per acquisition.
    • Establish current metrics for customer acquisition efficiency.
    • Create a process map of the customer acquisition journey.
    • Identify process variation and create control charts for baseline data.
    AnalyzeIdentify root causes of inefficiencies and high acquisition costs.
    • Perform a root cause analysis by creating a fishbone diagram that pinpoints key issues.
    • Analyze collected data for trends in customer drop-offs, slow lead response, and onboarding bottlenecks.
    • Conduct a gap analysis to compare current performance with target goals.
    • Prioritize the most impactful problems to address.
    ImproveImplement solutions to improve customer acquisition efficiency.
    • Develop improvement strategies that focus on enhancing lead follow-up, optimizing onboarding, and reducing cost per acquisition.
    • Pilot changes in a controlled environment to assess effectiveness.
    • Use brainstorming sessions and design future state process maps.
    • Implement the most effective changes across the customer acquisition process.
    • Measure initial results to track improvements.
    ControlSustain improvements.
    • Develop a control plan that outlines procedures to monitor and sustain improvements (e.g., dashboards and key performance indicators).
    • Train process owners and team members on the new processes.
    • Implement standard operating procedures (SOPs) for the improved process.
    • Conduct regular performance reviews and audits.
    • Hand over responsibility to the process owners, and transition to normal operations.

  2. Financial Impact: The Get Rich Financial Services Customer Acquisition Process Improvement project aims to significantly reduce the cost per acquisition and increase overall customer conversion rates, leading to measurable financial benefits. The following are the expected financial impacts:

    1. Cost Reduction: The current cost per acquisition (CPA) is approximately $200. By streamlining the customer acquisition process and eliminating inefficiencies, the project aims to reduce the CPA by 20 percent, bringing it down to $160. With an annual acquisition target of 5,000 new customers, this reduction would save approximately $200,000 per year ([$200 - $160] x 5,000).
    2. Increased Conversion Rate: The current lead-to-customer conversion rate is 5 percent. By improving lead follow-up processes and optimizing onboarding, the project aims to increase the conversion rate to 7 percent. This improvement is expected to bring in an additional 2,000 customers per year, translating to increased annual revenue of approximately $1 million, assuming an average customer lifetime value of $500.
    3. Return on Investment (ROI): The projected cost of the Six Sigma project, including personnel, data analysis, and process changes, is estimated to be $100,000. The combined savings from CPA reduction and revenue from increased conversion are estimated at $1.2 million annually, yielding a first-year ROI of 1,100 percent.
    4. Long-Term Impact: Sustaining these improvements over a five-year period is projected to result in total savings and additional revenue of approximately $6 million.

Downloadable Six Sigma Project Plan Template

Six Sigma Project Plan Template Example

Download a Blank Six Sigma Project Plan for
Microsoft Word  | Google Docs

Download an Example Six Sigma Project Plan for
Microsoft Word  | Google Docs

This Six Sigma project plan template is perfect for teams that need to identify inefficiencies, optimize operations, and ensure data-driven decision-making for measurable improvements. You can download the template, which features sections for project scope, goals, metrics, and roles, either pre-filled with the example above or as a blank version to customize for your own initiatives.

For help planning your next marking project, see this collection of marketing project plan templates in all formats.

Example Lean Project Plan

Lean project plans focus on delivering maximum customer value, rather than strictly adhering to predefined scope, timelines, and detailed phases as in traditional project plans. Instead of mapping out fixed deliverables milestones, Lean project managers and teams design continuously improving processes with tools such as value stream maps (VSM).

“Lean planning focuses on efficiency, eliminating waste, and maximizing value,” says Ramlugan. “A key element unique to Lean is the value stream map, which tracks the flow of tasks to ensure that every step adds value to the final product. Unlike other methodologies, Lean emphasizes continuous improvement and rapid iteration, making it ideal for process optimization projects.”

Here is an example VSM to include in a Lean project plan:

VSM Lean Project Plan Example

Find free templates to create a value stream map such as this one in this collection of VSM templates.

Milestone Project Plan Example

milestone graphic in a project plan clearly and visually lays out key phases of the project so stakeholders can easily track progress. In this example of a remote work policy overhaul, the HR team can plot milestones, such as researching best practices and revising the policy along a simple timeline, to ensure transparency and alignment.​

Milestone Project Plan

For more resources to plan your next human resources project, see this collection of HR project planning templates, including a staffing plan template and a strategic planning template.

Cross-Functional Project Plan Example

The example shows a cross-functional process flowchart that you can incorporate into a project plan to help clarify roles and responsibilities. This kind of swimlane diagram helps prevent confusion, especially when teams that usually don’t work together are assigned to the same project.

Cross Functional Project Plan Example

Notice how each swimlane represents the department responsible for specific tasks, showing how the process flows between them.

Mind Map Project Plan Example

mind map is a visual brainstorming tool that can help shape a project plan. It typically starts with the project’s main goal or objective at the center of the diagram, then branches out into related categories, such as tasks, resources, timelines, risks, and stakeholders.

Mind Map Project Plan Example

Project Plan Common Elements

The common elements of a project plan typically include the executive summary, project scope, objectives and goals, timeline and milestones, roles and responsibilities, cost baseline, cost control plan, risk management plan, communication plan, and project evaluation and selected success metrics.

Depending on the type of project or the project management methodology you are using, you may need additional sections. Alternatively, you can adapt these elements to fit your specific approach.

Here are the common elements found in all comprehensive project plans:

  • Executive Summary: Provide a brief overview of the project, its purpose, and key objectives to give stakeholders a clear understanding of the project’s goals.
  • Project Scope: Define the boundaries of the project, including what is and isn’t included. Doing so helps ensure alignment on deliverables and key activities.
  • Objectives and Goals: List the key outcomes the project aims to achieve so you can focus efforts on measurable success.
  • Timeline and Milestones: Outline the project phases and significant deadlines. Doing so allows teams to track progress and stay on schedule.
  • Roles and Responsibilities: Clearly define the specific duties and tasks assigned to each team member or stakeholder. Note the main point of contact for each team.​
  • Cost Baseline: Establish the approved project budget to serve as a reference point for tracking and controlling actual expenses.
  • Cost Control Plan: Describe how the project budget will be managed and controlled to prevent cost overruns and ensure financial accountability.
  • Risk Management Plan: Identify potential risks and outline mitigation strategies to prevent disruptions.
  • Communication Plan: Outline how information will be shared among stakeholders, including the frequency of updates, communication methods, and key points of contact.
  • Project Evaluation and Success Metrics: Detail how the project’s success will be measured, and provide clear criteria for evaluating outcomes and performance.

Common Elements Found in Each Type of Project Plan

The structure of a project plan will vary depending on the methodology you are using, project scope, team size, and other factors. For example, a Waterfall project plan is typically linear, with a fixed timeline and scope. In contrast, Agile projects focus on iterative development, with flexible timelines and evolving scope.

Other factors, such as project complexity, available resources, and industry-specific requirements, will also influence how a plan is structured. For example, the plan might include detailed risk management in highly regulated industries or more fluid communication protocols in creative projects.

Here is a comprehensive chart that lays out the differences between project plans in common project management methodologies:

Project Plan Comparison Chart by Methodology

Download the Project Plan Comparison Chart by Methodology for Adobe PDF

Download this printable comparison chart for a quick reference when selecting the right format and sections for your next project plan. This chart highlights key aspects, such as planning style, the level of detail and rigidity required in the scope statement, timeline flexibility, and the types of projects best suited for each methodology.

Successfully Plan and Execute Your Project With Smartsheet for Project Management

From simple task management and project planning to complex resource and portfolio management, Smartsheet helps you improve collaboration and increase work velocity -- empowering you to get more done.

The Smartsheet platform makes it easy to plan, capture, manage, and report on work from anywhere, helping your team be more effective and get more done. Report on key metrics and get real-time visibility into work as it happens with roll-up reports, dashboards, and automated workflows built to keep your team connected and informed.

When teams have clarity into the work getting done, there’s no telling how much more they can accomplish in the same amount of time. Try Smartsheet for free, today.
